Case study · Commercial · Des Moines, Iowa
Two years before there was a hole in the ground
The owners spent five years getting Paws & Pints open, and a pandemic landed in the middle of them. We started flying for it in September 2019 — twenty months before anyone broke ground — when the whole thing was still an idea that needed explaining to other people.
That first stretch was due diligence. We filmed comparable businesses so the owners could study what actually worked and show other people what they meant: a venue in Kansas City built around the same idea, a canine training center in Ankeny, a pet food and treats store in Urbandale. We filmed the service lines they already knew they wanted, too — grooming, training, daycare, agility, supplies — two years before a single one of them existed here. Then we flew the build itself, nine times, from bare grass to the first customers in the car park.

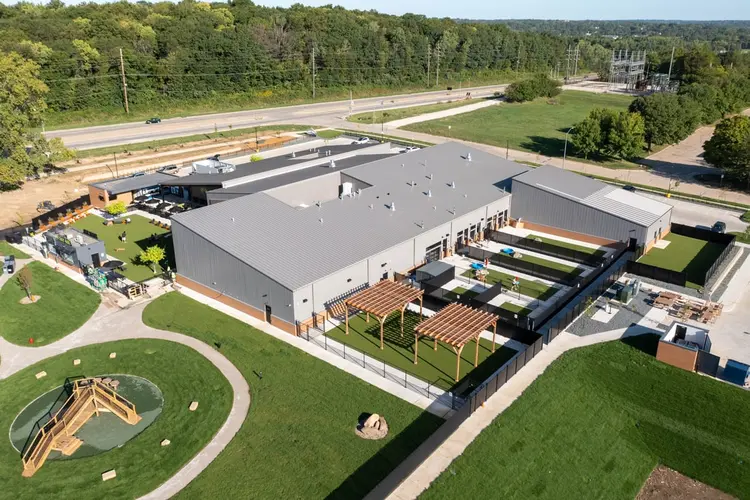

Paws & Pints, 3 September 2022 — open, planted, and being used. Seven acres that were pasture the first time we flew over them.
- Project
- Paws & PintsCanine retreat & social, Des Moines
- Working together
- 3 yearsSep 2019 due diligence – Sep 2022 opening
- Build flights
- 929 May 2021 – 3 Sep 2022
- Site
- ~7 acresIndoor and outdoor
What they actually built
It would be easy to file this as “a dog park with a bar”, and that undersells it by a wide margin. Paws & Pints is a venue. You can sit down with a drink and genuinely relax while your dog runs itself stupid on seven acres it does not have to be supervised across — and that alone would have been enough of a business.
They did not stop there. Boarding, training, grooming, daycare, an agility course, a supplies boutique, indoor parks for when Iowa is being Iowa. Almost none of that is what you expect behind a sign that says dog park, and all of it was in the plan back in 2019, which is why we were filming those service lines two years before there was a building to put them in.
Five years from idea to open doors, with COVID in the middle of it. The pictures are the easy part of that story; the owners did the hard part.
Nobody had to care yet
That is the quiet terror of opening a venue. On day one it needs people to already know it exists, already understand what it is, and already want to drive across town for it — and for the years beforehand the only thing it has to show for itself is a field, then a hole, then a construction site.
So the flying here was never a reporting obligation, it was the marketing asset. Steel going up is genuinely interesting to people who have never watched a building get built, and a concept this legible explains itself from the air in a way it never does from the ground. The same hour that records the schedule produces the thing you post — which is the whole argument for starting in 2019 rather than at substantial completion.

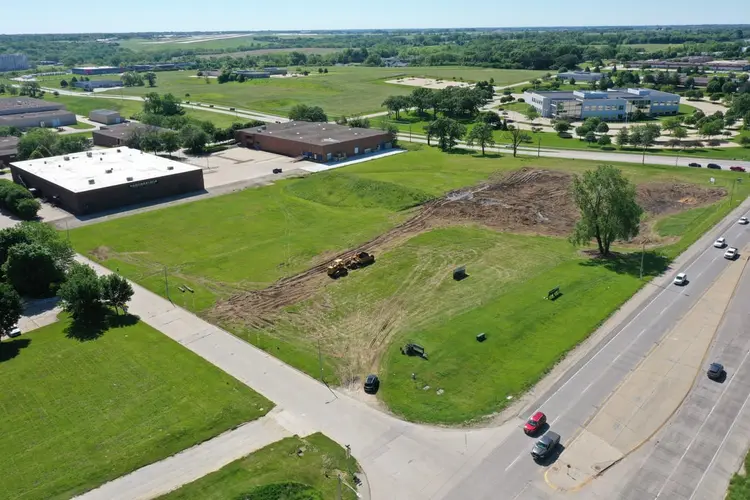

May 2021 to September 2022

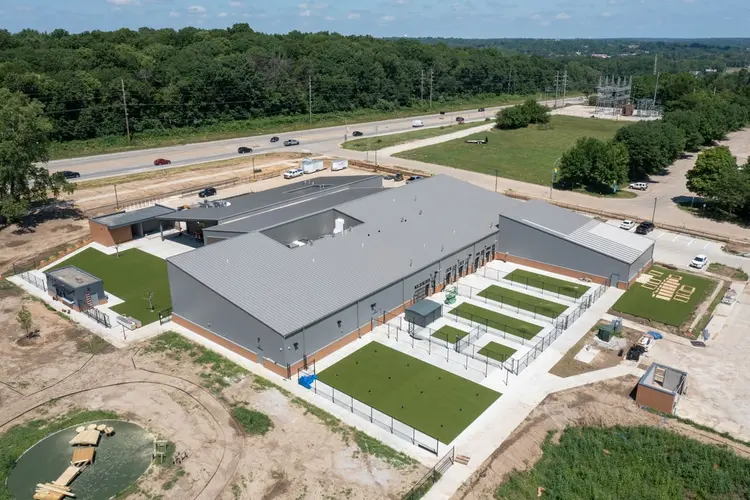

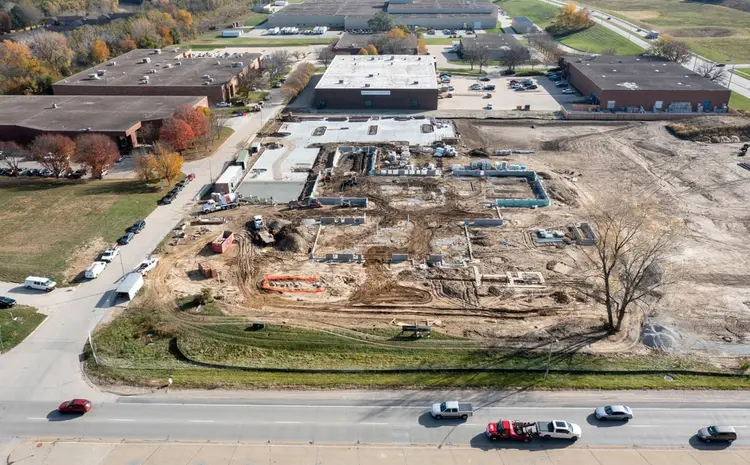

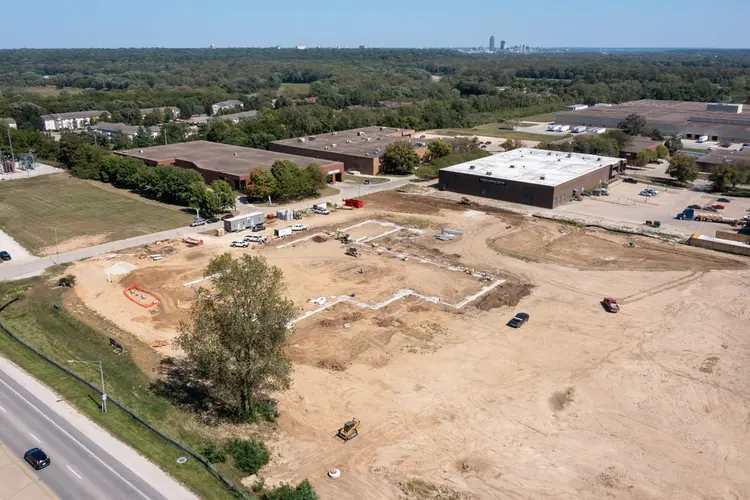

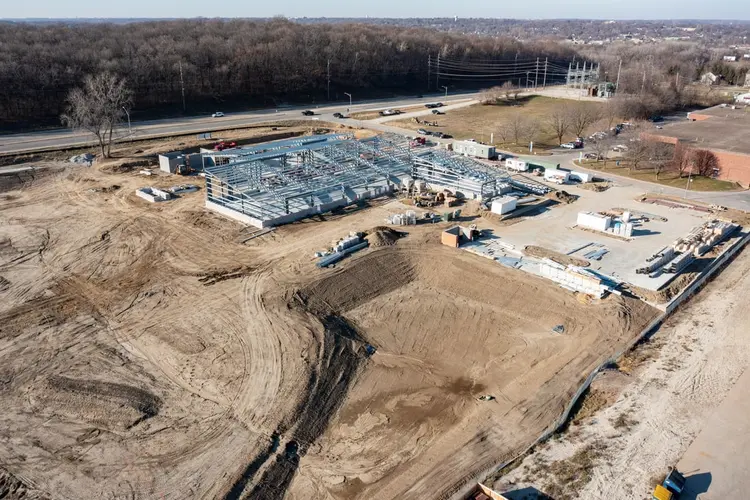

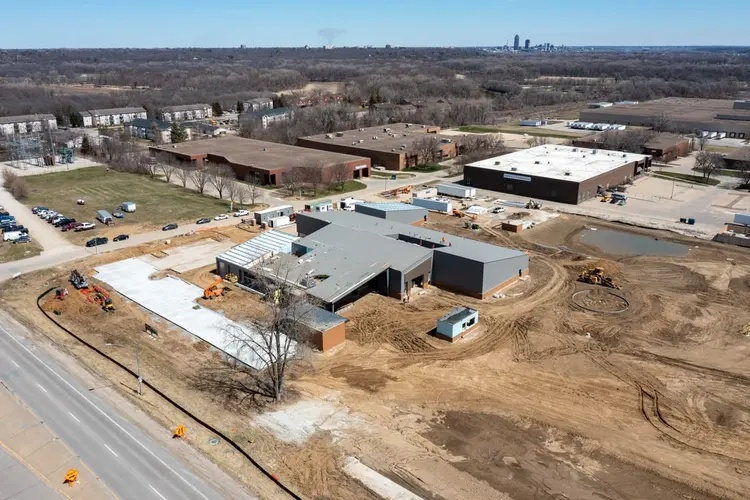

Nine flights, seven of them below. Read across: grass and a project sign; the first cut and the footings by late summer; foundations through autumn; steel before Christmas; the shell enclosed by spring; the building finished and the grounds still raw in July; and a working dog park by September.







Seven of the nine flights, 29 May 2021 to 3 September 2022. The two omitted are a February visit and a May one that sit between frames that already read clearly.
The whole idea in one frame

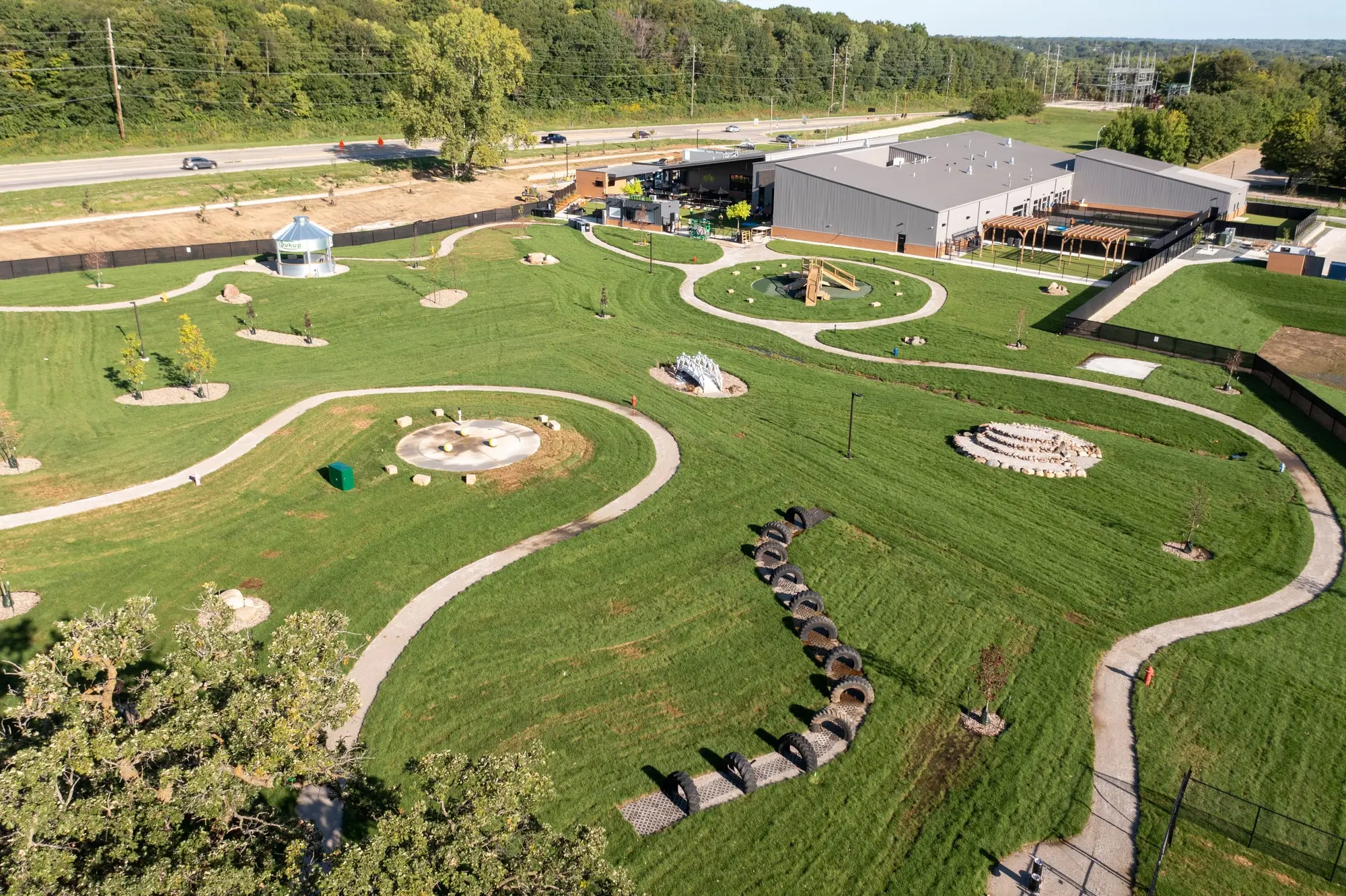

This is the picture the business could not take any other way, and it is the one that explains the concept fastest: a dog park designed as a landscape rather than a fenced rectangle — winding paths, mounds, ponds, an agility run, shade trees — wrapped around a building with turf runs and a patio, and a car park sized for people who intend to stay a while.

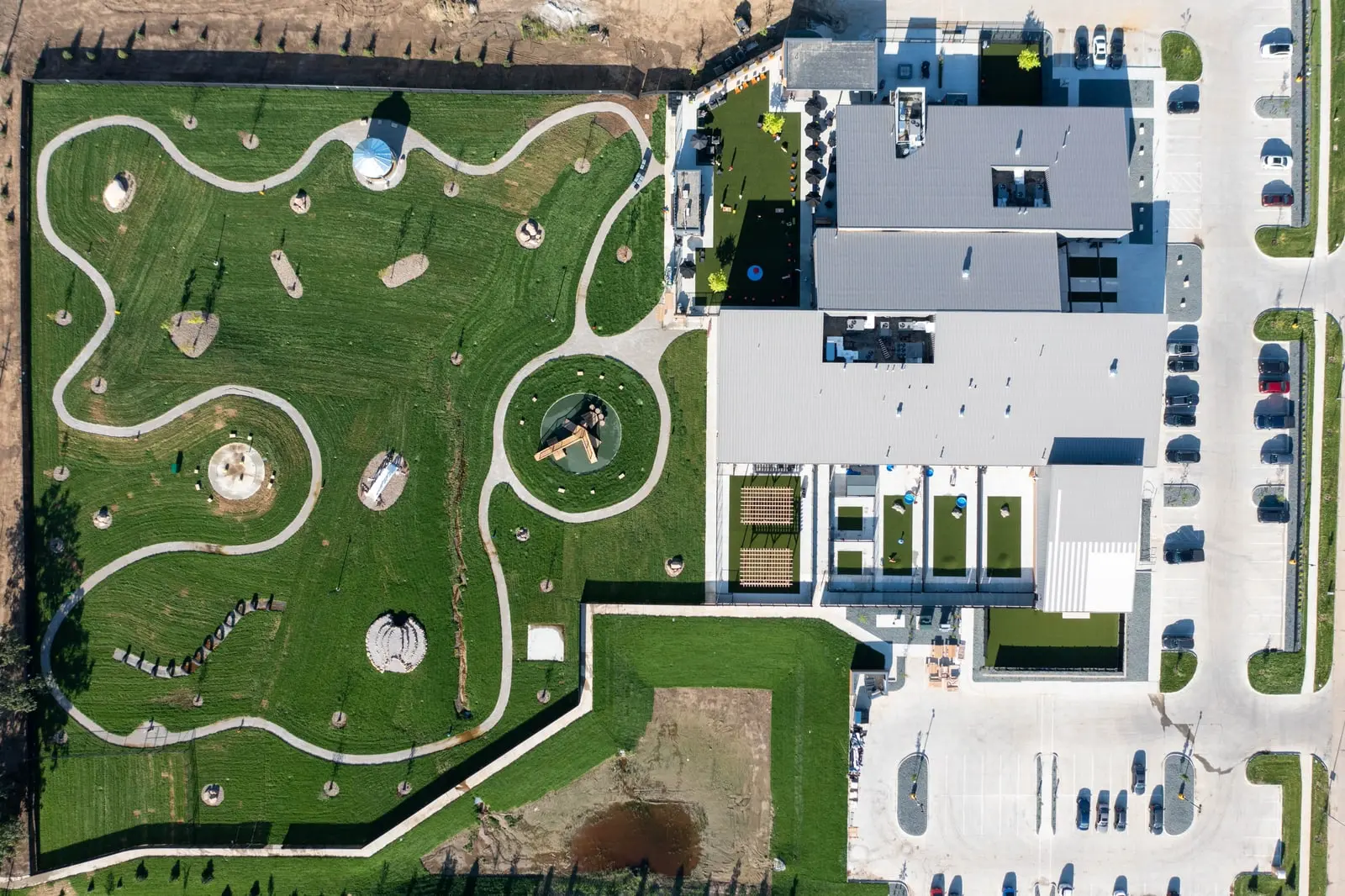

3 September 2022. From directly overhead the layout reads as a plan drawing that happens to be real — which is exactly what a new business wants to show people who have never been.

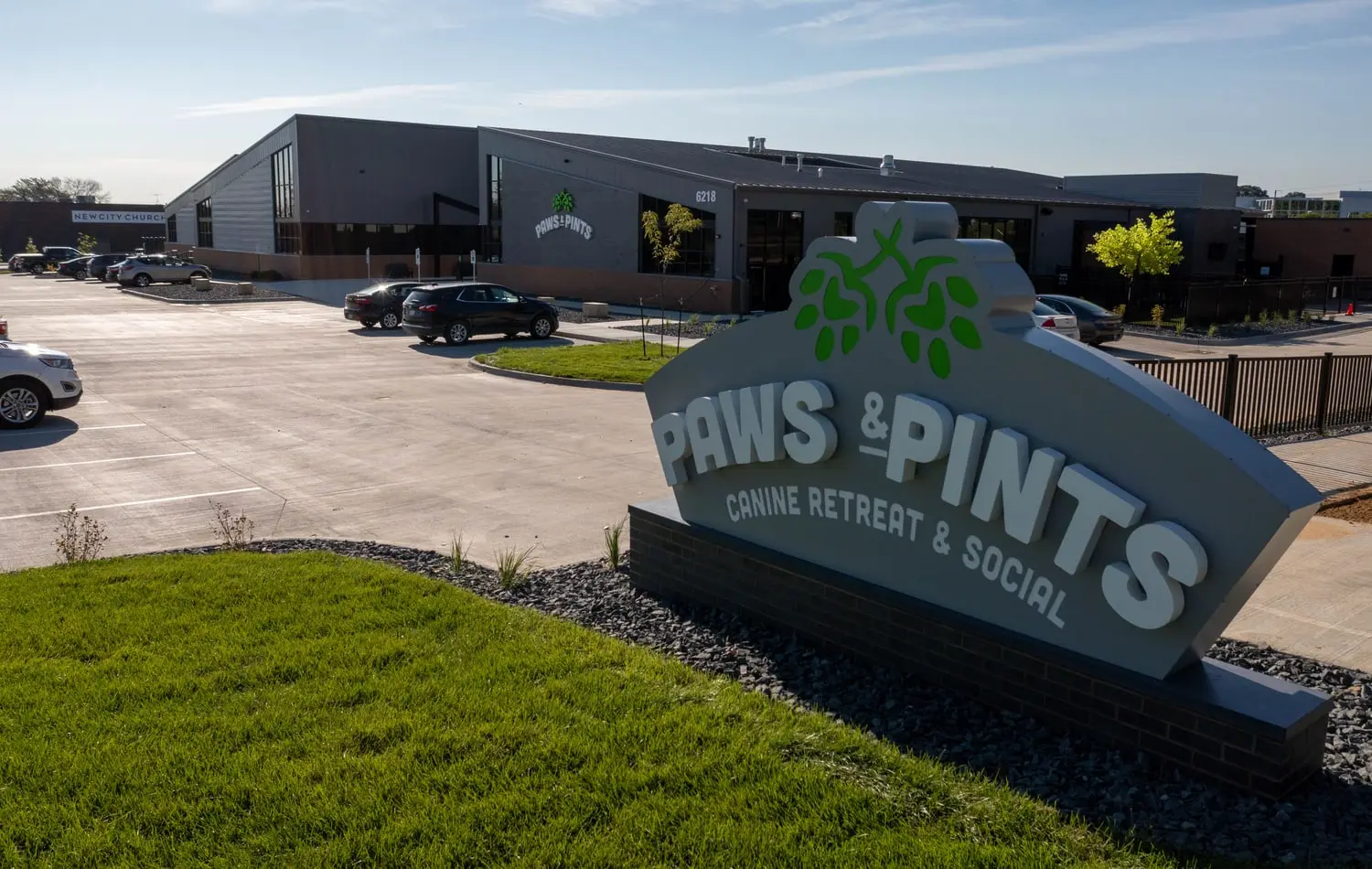

Same idea, fifteen months apart
The first flight and the last both found a sign. The difference between them is the whole project.
What the owners ended up holding
Three years of material: due-diligence film from before there was a site, then fifteen months of dated frames. During the build that is a steady supply of something to show an audience that does not exist yet. Afterwards it is the only record of how the place was actually made. Both halves matter, and they have different shelf lives — the launch material is spent in a season, the record is not.

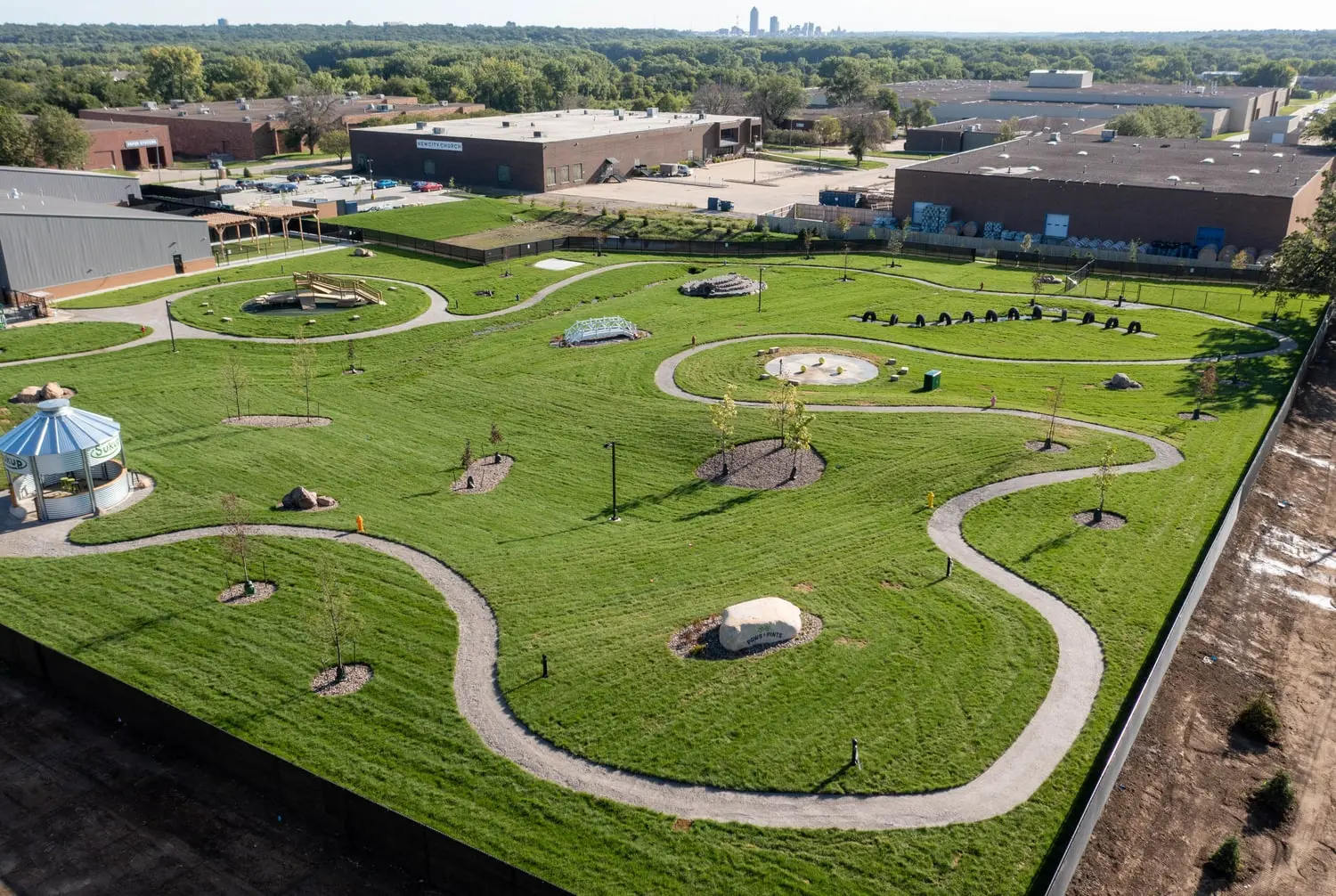

The park from the south-west, with downtown Des Moines on the horizon — the shot that places a suburban business in its city.
It is also the cheapest part of the project by a wide margin. A documentation flight is one operator, one aircraft and about an hour on site. Spread across three years it is a rounding error against the build, and it is the only line item still working for the business four years later.
Opening something people have to know about before day one? Start earlier than feels reasonable — the build is the only story you have until the doors open.
Start a documentation program →Paws & Pints is at 6218 Willowmere Drive, Des Moines, on a site of about seven acres, and opened in August 2022 — five years after the owners first had the idea, as their own account of it tells the story. The design and construction team — Hotshot Architecture, Downing and JM Commercial — is credited from the public project sign photographed on 29 May 2021. Due-diligence filming began in September 2019. Imagery flown under FAA Part 107.
